Risks

Location/Item Risk Priority Mitigation Plan Status
APAC/CoVid-19 Staff health and well-being High Additional agreed cleaning and order and supply of PPE and masks In progress
BLR04 – FAS system obsolete Failure of fire detection High PPM under close monitoring. BOQ submitted for replacement In progress
BLR01-05/Canopy damage Water sagging and canopy fall High BLR04 canopy isolated and BOQ submitted for replacement In progress
BLR04 Cooling tower frame corroded HVAC failure to occupants High Regular inspection and consultant engaged for rectification works In progress
BLR04 Façade support structure is damaged Structure collapse and injury High Temporary support in place. Consultant testing ongoing In progress
TYO05 network cabling disorganised Electrical fire High Daily inspections in place. Discussion wit IT required for final clear of room. In progress
BLR Campus- overdue hazardous waste licence Compliance issue High Online application complete and proposing to engage external consultant to close out In progress
PVG01-07 Lack of fire extinguishers in hub rooms Lack of fire suppression High Purchased and installed Closed

Vendor Performance

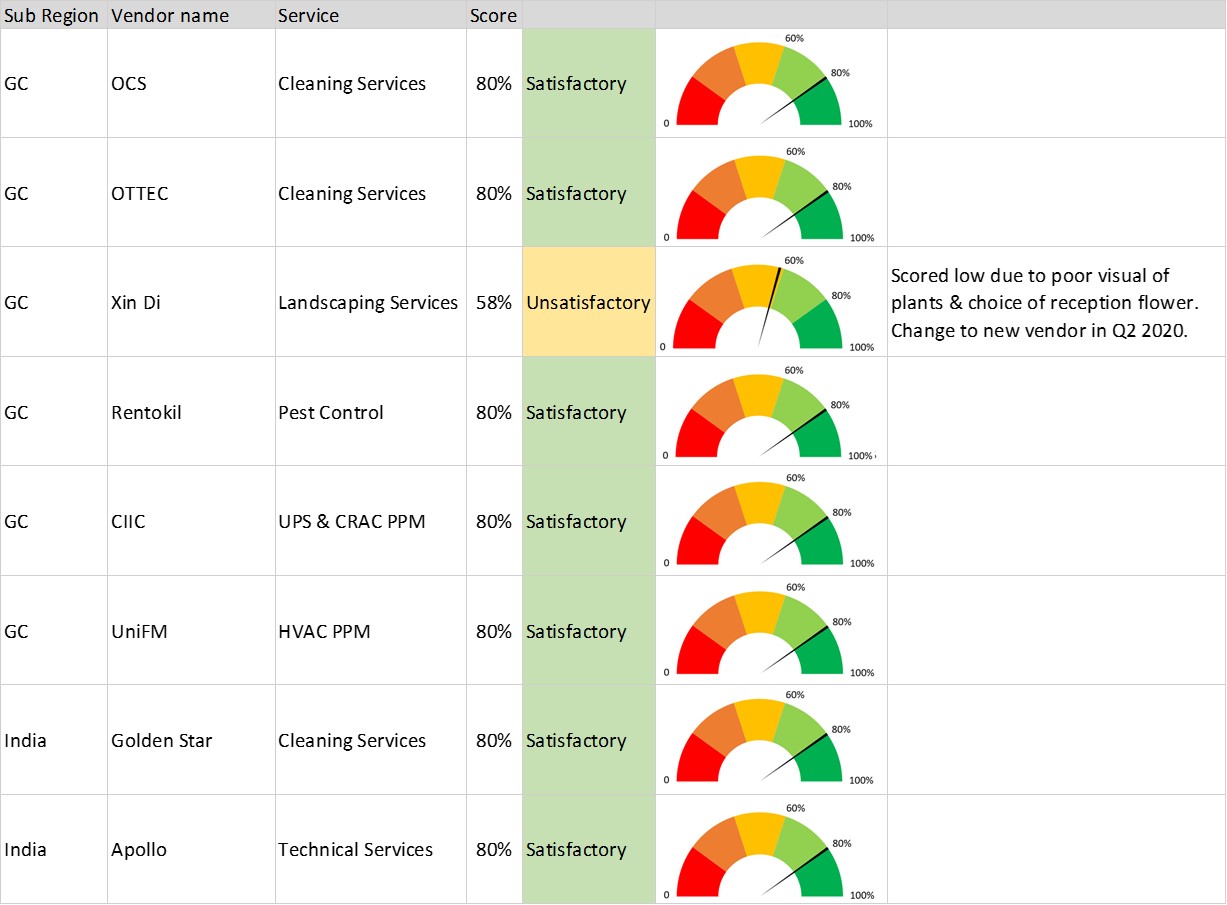

  • China – Shanghai xin di landscaping co.,LTD – Scored low in Q3 and Q4 as visual image of some plants poor and poor choice of reception flowers. Vendor is cooperative but needs to take more proactive approach. Decision has been made to change vendor at end of Q1 2020.

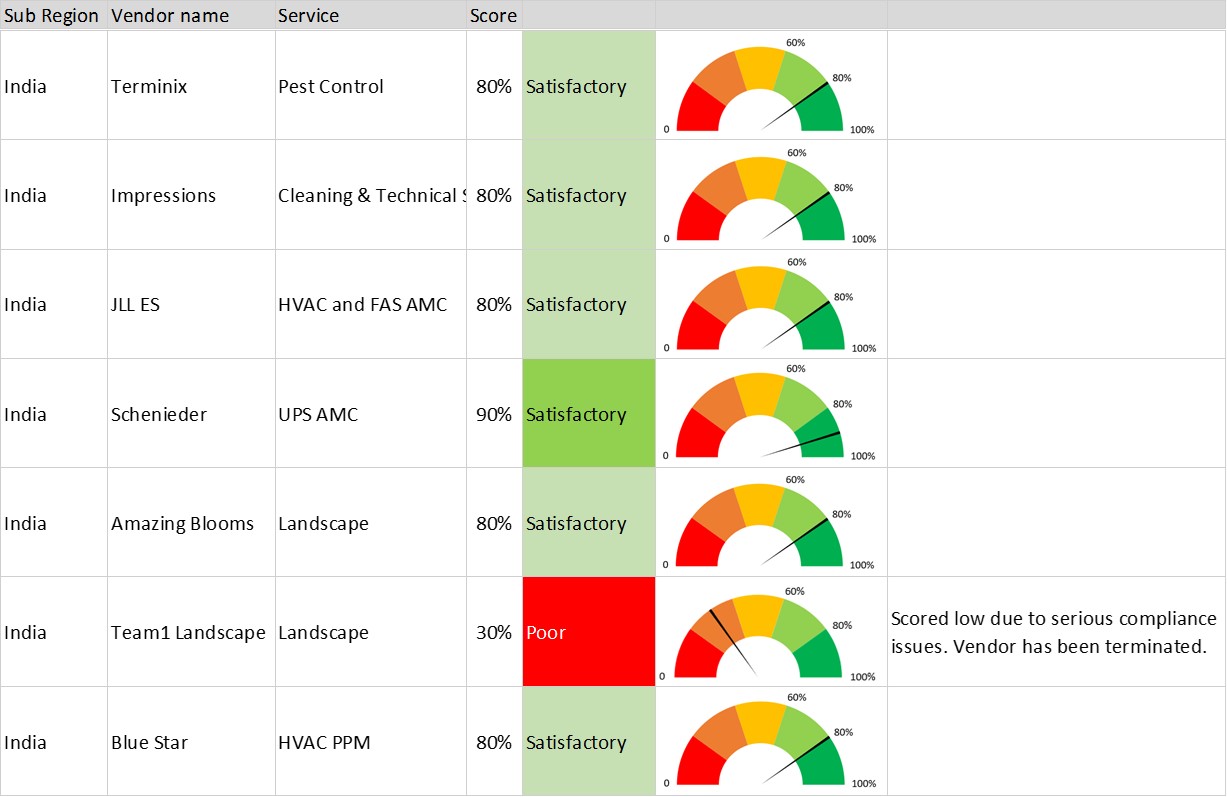

  •  India- Changed BLR campus Landscape vendor in December due to labour compliance issues in payments to staff

Incidents

4 incidents logged in Q4

  •  Incident 1: MNL 03/04 faced a power interruption from mains supply. There was temporary power from the genset till mains power was restored.
  •  Incident 2: MNL 02 faced a power fluctuation and the UPS bypass failed. Schneider rectified the issue on the same day
  •  Incident 3: BLR10- AC duct fell from a higher floor but was a near miss. It was not found to be from SAP tenancy but loose assets were found on open teraces and were subsequently tied down across the portfolio.
  •  Incident 4: SIN05 water leakage which resulted in parts of office closed for rectification.

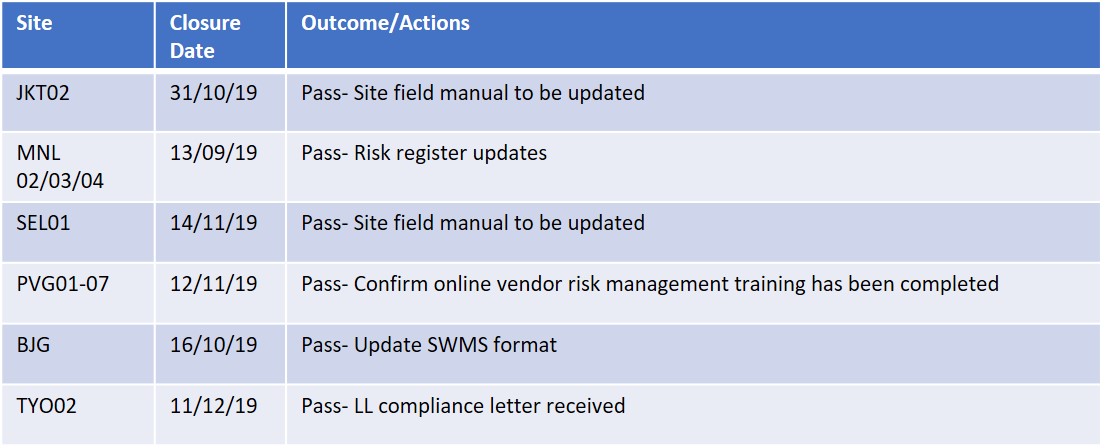

Audits

Pending items are Bagmane Tech Park audits planned end Q4/start Q1 which have been cancelled
